Construction Site Inspection Checklist
A practical construction site inspection checklist covering safety, housekeeping, equipment and work quality, and how to run inspections so the findings get fixed.
A site inspection is only useful if it is done the same way every time and someone acts on what it finds. A clipboard checklist that ends up in a drawer manages neither. Below is a checklist to start from and adapt, and then some advice on running inspections so they change what happens on site.
A starting checklist
Access and site security
- Perimeter fencing intact, gates closed and signed.
- Site induction completed for everyone on site today.
- Visitor log in use.
Safety
- PPE worn: helmets, boots, high-visibility clothing, and gloves and eye protection where required.
- Scaffolding tagged and inspected, with guardrails and toe boards in place.
- Edges, openings and excavations protected.
- Ladders secured and in good condition.
- Fire extinguishers present, charged and accessible.
- First aid kit stocked and a first aider on site.
Housekeeping
- Walkways clear of materials and debris.
- Waste in skips, not piled on the floor.
- Materials stored safely and stacked securely.
Electrical and equipment
- Temporary electrics protected, with cables off the ground or covered.
- Portable tools inspected and in date.
- Plant operated only by trained people, with daily checks done.
Work quality
- Work matches the drawings for the areas inspected.
- Findings from the previous inspection closed.
Keep each line short enough to tick. You can tick "Scaffolding tagged"; you cannot tick "ensure scaffold safety".
Mark what must be done
Some items cannot be skipped, such as induction, fall protection and fire extinguishers. Make them required so the inspection cannot be closed without them.
Record findings as well as ticks
A tick means the item was fine. When it is not, record a finding with:
- what is wrong, with a photo;
- where it is on site;
- how serious it is: low, medium, high or critical;
- who will fix it, and by when.
A finding should stay open until someone closes it, and the next inspection should begin by checking the open ones.
Prove the inspection happened
Record when the inspector started and where they were, and get the site manager to sign off at the end. Photos of the main areas protect everyone if something goes wrong later.
Inspect on a schedule
Most sites need a weekly inspection, and high-risk phases a daily one. Put inspections on a schedule so they still happen when the site is busy.

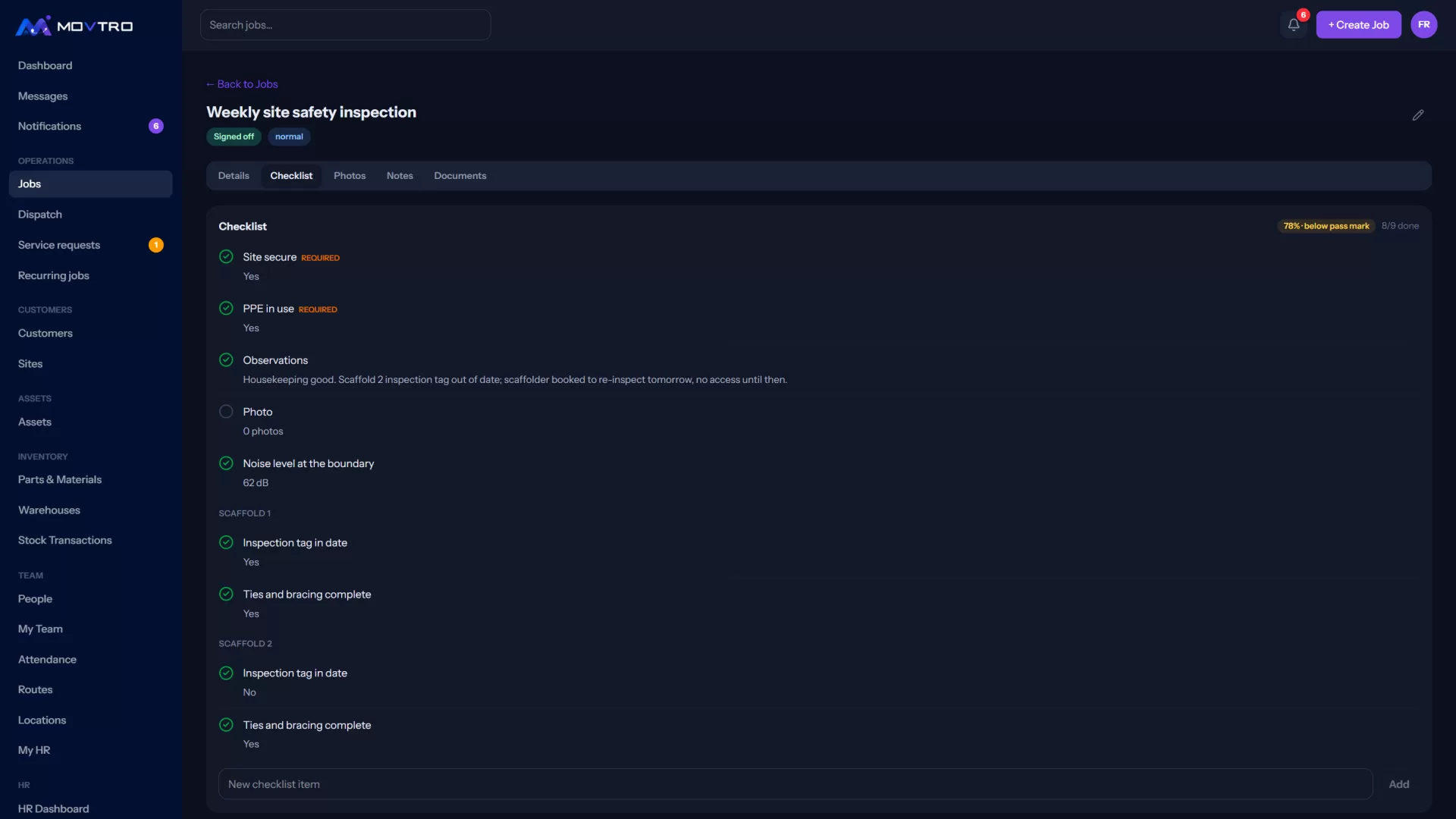

In Movtro

In Movtro an inspection is a job at the site with a checklist, and required questions must be answered before it can be completed. When the inspector starts it, Movtro records where they were and how far that was from the site. Photos, notes and the site manager's signature are captured on the phone, without signal if necessary. Findings are reported on the job with a category (such as safety issue or site condition) and a severity. They stay open until resolved and can be escalated by automation rules. Recurring jobs schedule weekly or daily inspections.
A question can be answered yes/no/N-A, with a reading that has an expected range, or with a photo of the step. A follow-up question can be set to appear only after a particular answer, and a group of questions can repeat for each scaffold or floor inspected. Questions can carry points and the job type can set a pass mark, with the score shown on the job, in the portal and on the service report. A reading outside its range reports a problem on the job automatically. Report any other failed item as a problem too, so it stays open until it is fixed.
